Timezone support in Blazor Gantt Chart
8 Jul 202616 minutes to read
The Blazor Gantt Chart component schedules and displays dates and times based on the system timezone by default. To configure it to use a specific timezone, assign a standard IANA timezone string such as UTC or America/New_York to the Timezone property.
This configuration ensures that task dates, event markers, baseline dates, and indicators are interpreted and rendered in the specified timezone. It also automatically adjusts for daylight saving time (DST) transitions, providing accurate scheduling and visualization across different regions.
Timezone date conversion
The Timezone property allows the Gantt Chart to convert and display all task-related dates, including start dates, end dates, event markers, and baseline dates, in the specified timezone.
For example, a DateTime value defined as new DateTime(2025, 2, 4, 8, 0, 0) in a system set to Pacific Standard Time (PST, UTC-08:00) will be adjusted to 2025-02-03 09:30 PM when the Timezone property is set to America/New_York (ET, UTC-05:00 during standard time).
This conversion ensures accurate scheduling and visualization across timezones, with adjustments for daylight saving time where applicable.
Setting the Timezone
Set the Timezone property to a valid IANA timezone string such as UTC, America/New_York, or Europe/London. This ensures consistent task date displays and aligns taskbars with database times.

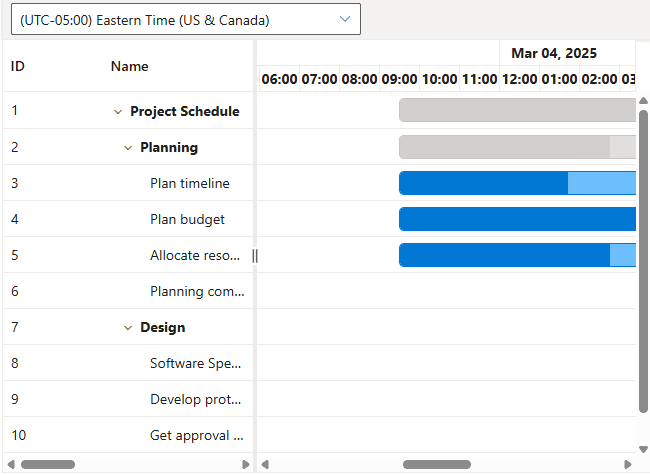

The following example demonstrates configuring the Gantt Chart with the America/New_York timezone and includes a dropdown to dynamically update the timezone, triggering a re-render of all task dates.
@using Syncfusion.Blazor.Gantt
@using Syncfusion.Blazor.DropDowns
@using Syncfusion.Blazor.Navigations
<SfGantt DataSource="@TaskCollection" Toolbar="@toolbarItems" DateFormat="d MMM yyyy hh:mm tt" IncludeWeekend="true" DurationUnit="DurationUnit.Hour" Height="475px" Width="650px" Timezone="@TimeZone"
TreeColumnIndex="1">
<GanttTaskFields Id="TaskID" Name="TaskName" StartDate="StartDate" EndDate="EndDate" Duration="Duration" Progress="Progress"
Dependency="Predecessor" ParentID="ParentID"></GanttTaskFields>
<GanttDayWorkingTimeCollection>
<GanttDayWorkingTime From="0" To="23"></GanttDayWorkingTime>
</GanttDayWorkingTimeCollection>
<GanttTimelineSettings TimelineUnitSize="40">
<GanttTopTierSettings Unit="TimelineViewMode.Day" Format="MMM dd, yyyy"></GanttTopTierSettings>
<GanttBottomTierSettings Unit="TimelineViewMode.Hour" Count="1" Format="hh:mm"></GanttBottomTierSettings>
</GanttTimelineSettings>
</SfGantt>
@code {
public List<TaskData>? TaskCollection { get; set; }
private List<Object>? toolbarItems;
public string TimeZone { get; set; } = "America/New_York";
public string SelectedTimeZone { get; set; } = "America/New_York";
public class TimeZoneFields
{
public string? Id { get; set; }
public string? Text { get; set; }
}
private static List<TimeZoneFields> TimeZoneValues = new List<TimeZoneFields>()
{
new TimeZoneFields { Id = "Etc/UTC", Text = "(UTC) Coordinated Universal Time" },
new TimeZoneFields { Id = "America/New_York", Text = "(UTC-05:00) Eastern Time (US & Canada)" },
new TimeZoneFields { Id = "America/Chicago", Text = "(UTC-06:00) Central Time (US & Canada)" },
new TimeZoneFields { Id = "America/Denver", Text = "(UTC-07:00) Mountain Time (US & Canada)" },
new TimeZoneFields { Id = "Europe/London", Text = "(UTC+00:00) Dublin, Edinburgh, Lisbon, London" },
new TimeZoneFields { Id = "Europe/Berlin", Text = "(UTC+01:00) Amsterdam, Berlin, Rome, Vienna, Stockholm" },
new TimeZoneFields { Id = "Asia/Kolkata", Text = "(UTC+05:30) Chennai, Kolkata, Mumbai, New Delhi" },
new TimeZoneFields { Id = "Asia/Tokyo", Text = "(UTC+09:00) Osaka, Sapporo, Tokyo" }
};
protected override void OnInitialized()
{
TaskCollection = GetTaskCollection().ToList();
toolbarItems = new List<object>()
{
new ItemModel
{
Id = "TimeZoneDropDown",
Align = ItemAlign.Left,
Template = (RenderFragment)(builder =>
{
builder.OpenComponent<SfDropDownList<string, TimeZoneFields>>(0);
builder.AddAttribute(1, "Width", "350px");
builder.AddAttribute(2, "DataSource", TimeZoneValues);
builder.AddAttribute(3, "Placeholder", "Select a Timezone");
builder.AddAttribute(4, "Value", SelectedTimeZone);
builder.AddAttribute(5, "ValueChanged", EventCallback.Factory.Create<string>(this, v => SelectedTimeZone = v));
builder.AddAttribute(6, "Text", "Text");
builder.AddAttribute(7, "ValueField", "Id");
builder.AddAttribute(8, "TItem", typeof(TimeZoneFields));
builder.AddAttribute(9, "ChildContent", (RenderFragment)(childBuilder =>
{
childBuilder.OpenComponent<DropDownListFieldSettings>(0);
childBuilder.AddAttribute(1, "Text", "Text");
childBuilder.AddAttribute(2, "Value", "Id");
childBuilder.CloseComponent();
childBuilder.OpenComponent<DropDownListEvents<string, TimeZoneFields>>(3);
childBuilder.AddAttribute(4, "ValueChange", EventCallback.Factory.Create<ChangeEventArgs<string, TimeZoneFields>>(this, OnTimeZoneChanged));
childBuilder.CloseComponent();
}));
builder.CloseComponent();
})
},
};
}
public async Task OnTimeZoneChanged(Syncfusion.Blazor.DropDowns.ChangeEventArgs<string, TimeZoneFields> args)
{
if (!string.IsNullOrEmpty(args.Value))
{
SelectedTimeZone = args.Value;
TimeZone = args.Value;
}
await Task.CompletedTask;
}
public class TaskData
{
public int TaskID { get; set; }
public string? TaskName { get; set; }
public DateTime? StartDate { get; set; }
public DateTime? EndDate { get; set; }
public string? Duration { get; set; }
public int Progress { get; set; }
public string? Predecessor { get; set; }
public int? ParentID { get; set; }
}
public static List<TaskData> GetTaskCollection()
{
List<TaskData> Tasks = new List<TaskData>()
{
new TaskData { TaskID = 1, TaskName = "Project Schedule", StartDate = new DateTime(2025, 3, 4, 8, 0, 0), EndDate = new DateTime(2025, 4, 10, 0, 0, 0), Progress = 0 },
new TaskData { TaskID = 2, TaskName = "Planning", StartDate = new DateTime(2025, 3, 4, 8, 0, 0), EndDate = new DateTime(2025, 3, 10, 0, 0, 0), ParentID = 1, Progress = 0 },
new TaskData { TaskID = 3, TaskName = "Plan timeline", StartDate = new DateTime(2025, 3, 4, 8, 0, 0), EndDate = new DateTime(2025, 3, 10, 0, 0, 0), Duration = "6", Progress = 60, ParentID = 2 },
new TaskData { TaskID = 4, TaskName = "Plan budget", StartDate = new DateTime(2025, 3, 4, 8, 0, 0), EndDate = new DateTime(2025, 3, 10, 0, 0, 0), Duration = "6", Progress = 90, ParentID = 2 },
new TaskData { TaskID = 5, TaskName = "Allocate resources", StartDate = new DateTime(2025, 3, 4, 8, 0, 0), EndDate = new DateTime(2025, 3, 10, 0, 0, 0), Duration = "6", Progress = 75, ParentID = 2 },
new TaskData { TaskID = 6, TaskName = "Planning complete", StartDate = new DateTime(2025, 3, 6, 8, 0, 0), EndDate = new DateTime(2025, 3, 10, 0, 0, 0), Duration = "0", Predecessor = "3FS,4FS,5FS", ParentID = 2, Progress = 0 },
new TaskData { TaskID = 7, TaskName = "Design", StartDate = new DateTime(2025, 3, 13, 8, 0, 0), EndDate = new DateTime(2025, 3, 17, 8, 0, 0), ParentID = 1, Progress = 0 },
new TaskData { TaskID = 8, TaskName = "Software Specification", StartDate = new DateTime(2025, 3, 13, 8, 0, 0), EndDate = new DateTime(2025, 3, 15, 0, 0, 0), Duration = "3", Progress = 60, Predecessor = "6FS", ParentID = 7 },
new TaskData { TaskID = 9, TaskName = "Develop prototype", StartDate = new DateTime(2025, 3, 13, 8, 0, 0), EndDate = new DateTime(2025, 3, 15, 0, 0, 0), Duration = "3", Progress = 100, Predecessor = "6FS", ParentID = 7 },
new TaskData { TaskID = 10, TaskName = "Get approval from customer", StartDate = new DateTime(2025, 3, 16, 8, 0, 0), EndDate = new DateTime(2025, 3, 17, 8, 0, 0), Duration = "2", Progress = 100, Predecessor = "9FS", ParentID = 7 },
new TaskData { TaskID = 11, TaskName = "Design complete", StartDate = new DateTime(2025, 3, 17, 8, 0, 0), EndDate = new DateTime(2025, 3, 17, 8, 0, 0), Duration = "0", Predecessor = "10FS", ParentID = 7, Progress = 0 }
};
return Tasks;
}

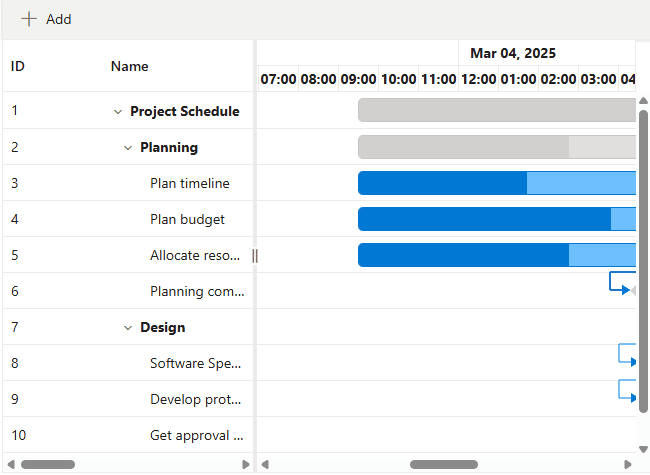

}CRUD operations with Timezone
CRUD operations in the Blazor Gantt Chart respect the configured Timezone property to ensure consistent date and time handling. When a task is added, the start date is calculated based on the minimum start date in the dataset and converted to the specified timezone. Editing or deleting tasks processes StartDate and EndDate values in the same timezone, maintaining consistency across visualization, data storage, and export operations.
The following sample demonstrates how to enable task creation, modification, and deletion in the America/New_York timezone. CRUD functionality is configured using GanttEditSettings properties (AllowAdding, AllowEditing, AllowDeleting, AllowTaskbarEditing). The Timezone property ensures accurate date conversion and display. GanttTaskFields support nullable StartDate and EndDate values, and GanttDayWorkingTimeCollection allows 24-hour scheduling.
@using Syncfusion.Blazor.Gantt
<SfGantt DataSource="@TaskCollection" Timezone="America/New_York" Toolbar="@(new List<string>() { "Add", "Edit", "Delete" })" DateFormat="d MMM yyyy hh:mm tt" IncludeWeekend="true" DurationUnit="DurationUnit.Hour" Height="475px" Width="650px"
TreeColumnIndex="1">
<GanttTaskFields Id="TaskID" Name="TaskName" StartDate="StartDate" EndDate="EndDate" Duration="Duration" Progress="Progress"
Dependency="Predecessor" ParentID="ParentID"></GanttTaskFields>
<GanttDayWorkingTimeCollection>
<GanttDayWorkingTime From="0" To="23"></GanttDayWorkingTime>
</GanttDayWorkingTimeCollection>
<GanttEditSettings AllowAdding="true" AllowDeleting="true" AllowEditing="true" AllowTaskbarEditing="true"></GanttEditSettings>
<GanttTimelineSettings TimelineUnitSize="40">
<GanttTopTierSettings Unit="TimelineViewMode.Day" Format="MMM dd, yyyy"></GanttTopTierSettings>
<GanttBottomTierSettings Unit="TimelineViewMode.Hour" Count="1" Format="hh:mm"></GanttBottomTierSettings>
</GanttTimelineSettings>
</SfGantt>
@code {
public List<TaskData>? TaskCollection { get; set; }
protected override void OnInitialized()
{
TaskCollection = GetTaskCollection().ToList();
}
public class TaskData
{
public int TaskID { get; set; }
public string? TaskName { get; set; }
public DateTime? StartDate { get; set; }
public DateTime? EndDate { get; set; }
public string? Duration { get; set; }
public int Progress { get; set; }
public string? Predecessor { get; set; }
public int? ParentID { get; set; }
}
public static List<TaskData> GetTaskCollection()
{
List<TaskData> Tasks = new List<TaskData>()
{
new TaskData { TaskID = 1, TaskName = "Project Schedule", StartDate = new DateTime(2025, 3, 4, 8, 0, 0), EndDate = new DateTime(2025, 4, 10, 0, 0, 0), Progress = 0 },
new TaskData { TaskID = 2, TaskName = "Planning", StartDate = new DateTime(2025, 3, 4, 8, 0, 0), EndDate = new DateTime(2025, 3, 10, 0, 0, 0), ParentID = 1, Progress = 0 },
new TaskData { TaskID = 3, TaskName = "Plan timeline", StartDate = new DateTime(2025, 3, 4, 8, 0, 0), EndDate = new DateTime(2025, 3, 10, 0, 0, 0), Duration = "6", Progress = 60, ParentID = 2 },
new TaskData { TaskID = 4, TaskName = "Plan budget", StartDate = new DateTime(2025, 3, 4, 8, 0, 0), EndDate = new DateTime(2025, 3, 10, 0, 0, 0), Duration = "6", Progress = 90, ParentID = 2 },
new TaskData { TaskID = 5, TaskName = "Allocate resources", StartDate = new DateTime(2025, 3, 4, 8, 0, 0), EndDate = new DateTime(2025, 3, 10, 0, 0, 0), Duration = "6", Progress = 75, ParentID = 2 },
new TaskData { TaskID = 6, TaskName = "Planning complete", StartDate = new DateTime(2025, 3, 6, 8, 0, 0), EndDate = new DateTime(2025, 3, 10, 0, 0, 0), Duration = "0", Predecessor = "3FS,4FS,5FS", ParentID = 2, Progress = 0 },
new TaskData { TaskID = 7, TaskName = "Design", StartDate = new DateTime(2025, 3, 13, 8, 0, 0), EndDate = new DateTime(2025, 3, 17, 8, 0, 0), ParentID = 1, Progress = 0 },
new TaskData { TaskID = 8, TaskName = "Software Specification", StartDate = new DateTime(2025, 3, 13, 8, 0, 0), EndDate = new DateTime(2025, 3, 15, 0, 0, 0), Duration = "3", Progress = 60, Predecessor = "6FS", ParentID = 7 },
new TaskData { TaskID = 9, TaskName = "Develop prototype", StartDate = new DateTime(2025, 3, 13, 8, 0, 0), EndDate = new DateTime(2025, 3, 15, 0, 0, 0), Duration = "3", Progress = 100, Predecessor = "6FS", ParentID = 7 },
new TaskData { TaskID = 10, TaskName = "Get approval from customer", StartDate = new DateTime(2025, 3, 16, 8, 0, 0), EndDate = new DateTime(2025, 3, 17, 8, 0, 0), Duration = "2", Progress = 100, Predecessor = "9FS", ParentID = 7 },
new TaskData { TaskID = 11, TaskName = "Design complete", StartDate = new DateTime(2025, 3, 17, 8, 0, 0), EndDate = new DateTime(2025, 3, 17, 8, 0, 0), Duration = "0", Predecessor = "10FS", ParentID = 7, Progress = 0 }
};
return Tasks;
}
}
